01 - What We Do

Eight capabilities. One TSA.

Project 01 Est. partnership 2020 - 2028
Government & Civic

Stage systems inspection, every year since 2020

Thirty-four counterweight lines, an orchestra pit lift and two panorama winches, assessed line by line every year. Third consecutive term since 2020.

Location
Gladstone, Queensland
Years
2020 - 2028
TSA Teams
Service & Inspection · Rigging
Scroll
At a glance
01 Client

Gladstone Regional Council

02 Challenge

A council-owned regional entertainment centre with a heavily used counterweight fly system, and an obligation to prove every year that it is safe to operate.

03 What we did

An annual inspection, maintenance and certification programme, plus the rectification and replacement equipment that follows from it.

04 Outcome

Three consecutive contract terms since 2020, and a venue whose stage machinery is now a tracked asset class rather than an unknown.

01 The Problem

The machinery that runs the season is the part nobody sees.

Gladstone Entertainment & Convention Centre is the regional centre's main performing arts and events venue, owned and run by Gladstone Regional Council. It carries a full counterweight fly system, an orchestra pit lift, panorama winches and a working schedule with a high turnover of visiting productions.

All of that sits above the stage, where nobody looks at it between shows. Counterweight systems are unglamorous and they last for decades, which is precisely the problem: rope, sheaves and locking rails wear slowly and quietly, and the venue has an obligation to demonstrate every year that the whole system is still safe to put people under.

A council also has to be able to plan. Stage machinery that is only assessed when something goes wrong is not an asset class, it is a queue of surprises attached to an unpredictable budget line.

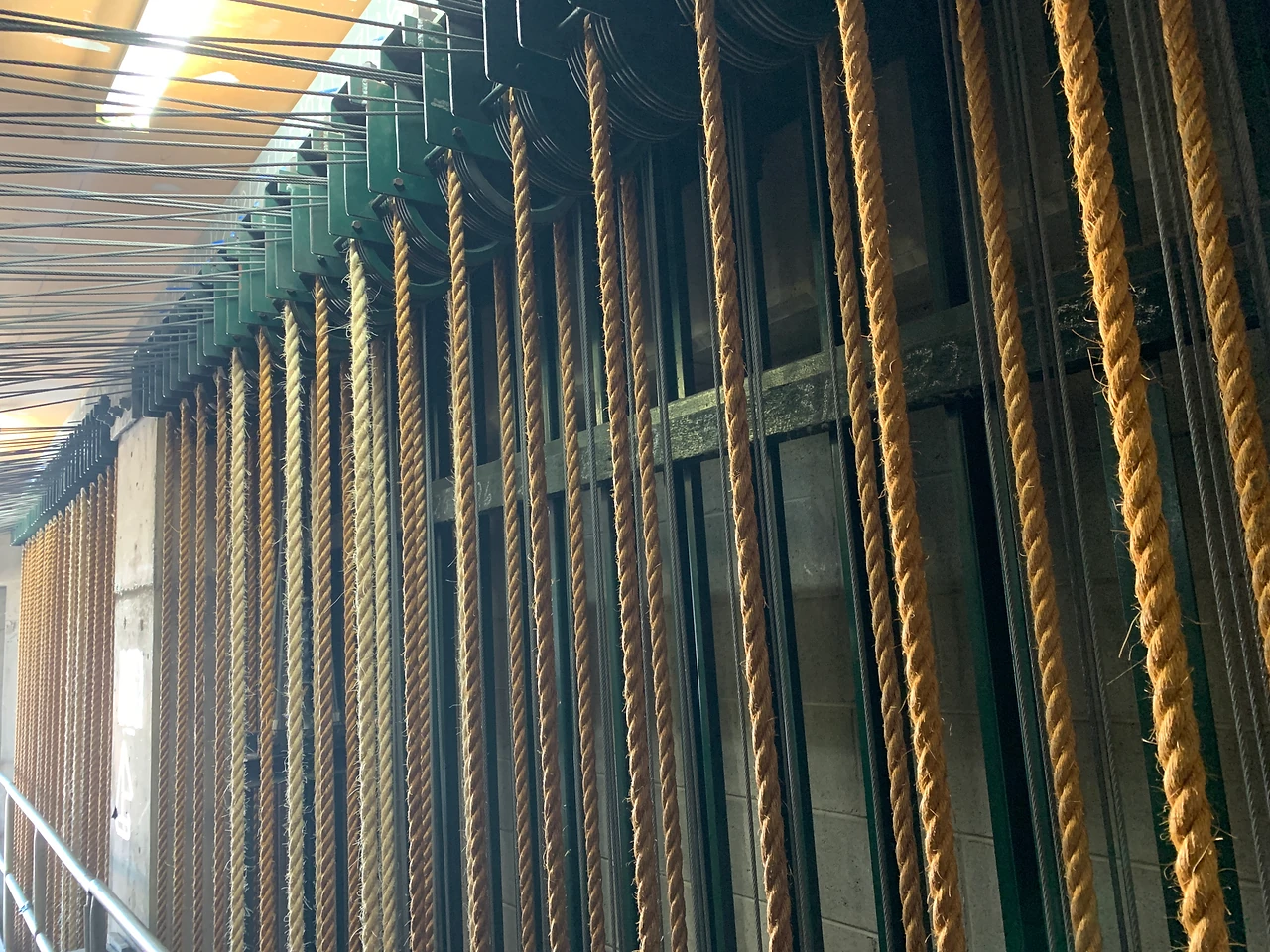

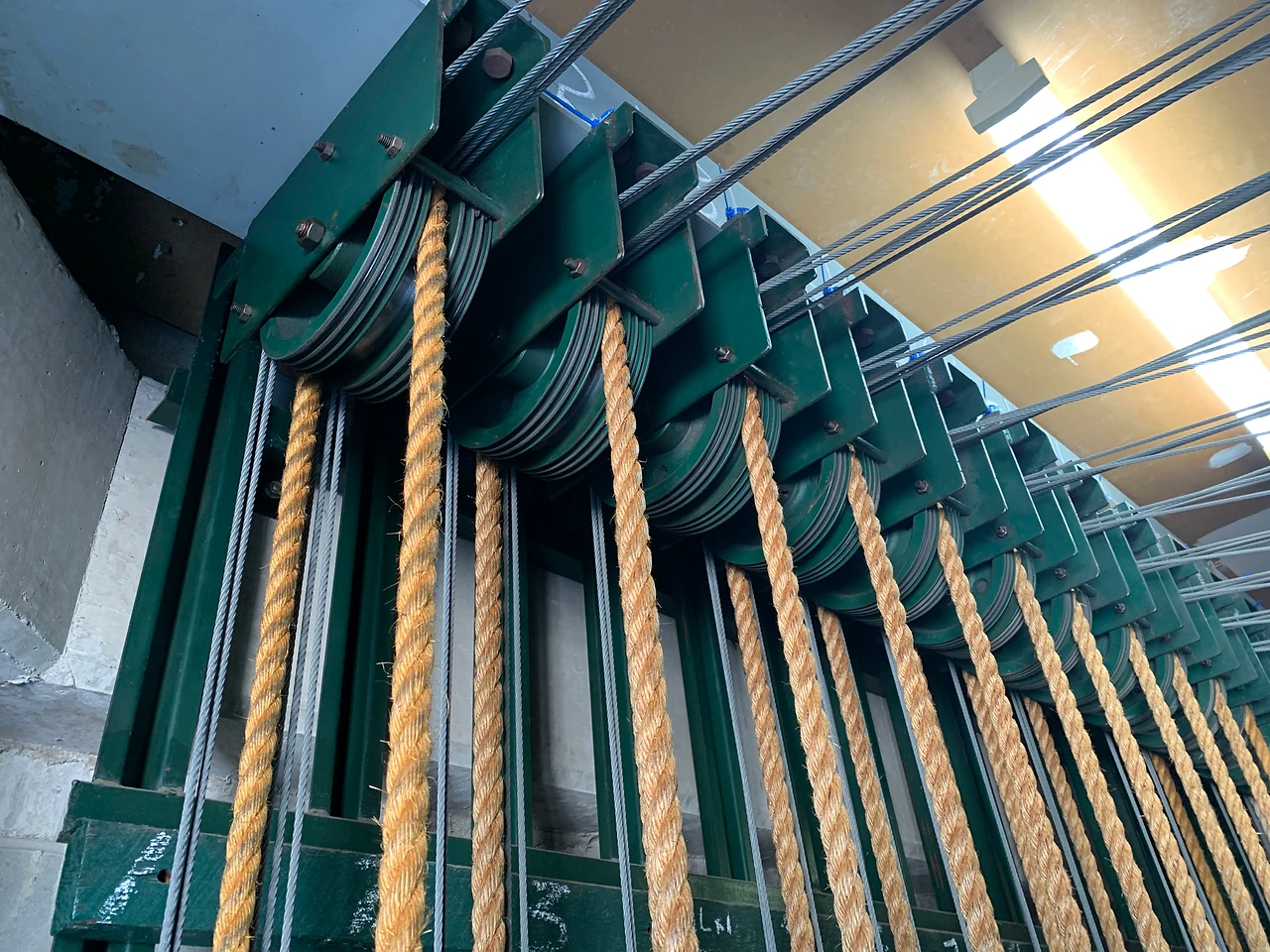

Hemp lines running down past the green arbours of the counterweight fly system at Gladstone Entertainment & Convention Centre.
Arena scale, projection, performer flying, all live, all night.
02 The Process

Assessed line by line, then actually fixed.

i

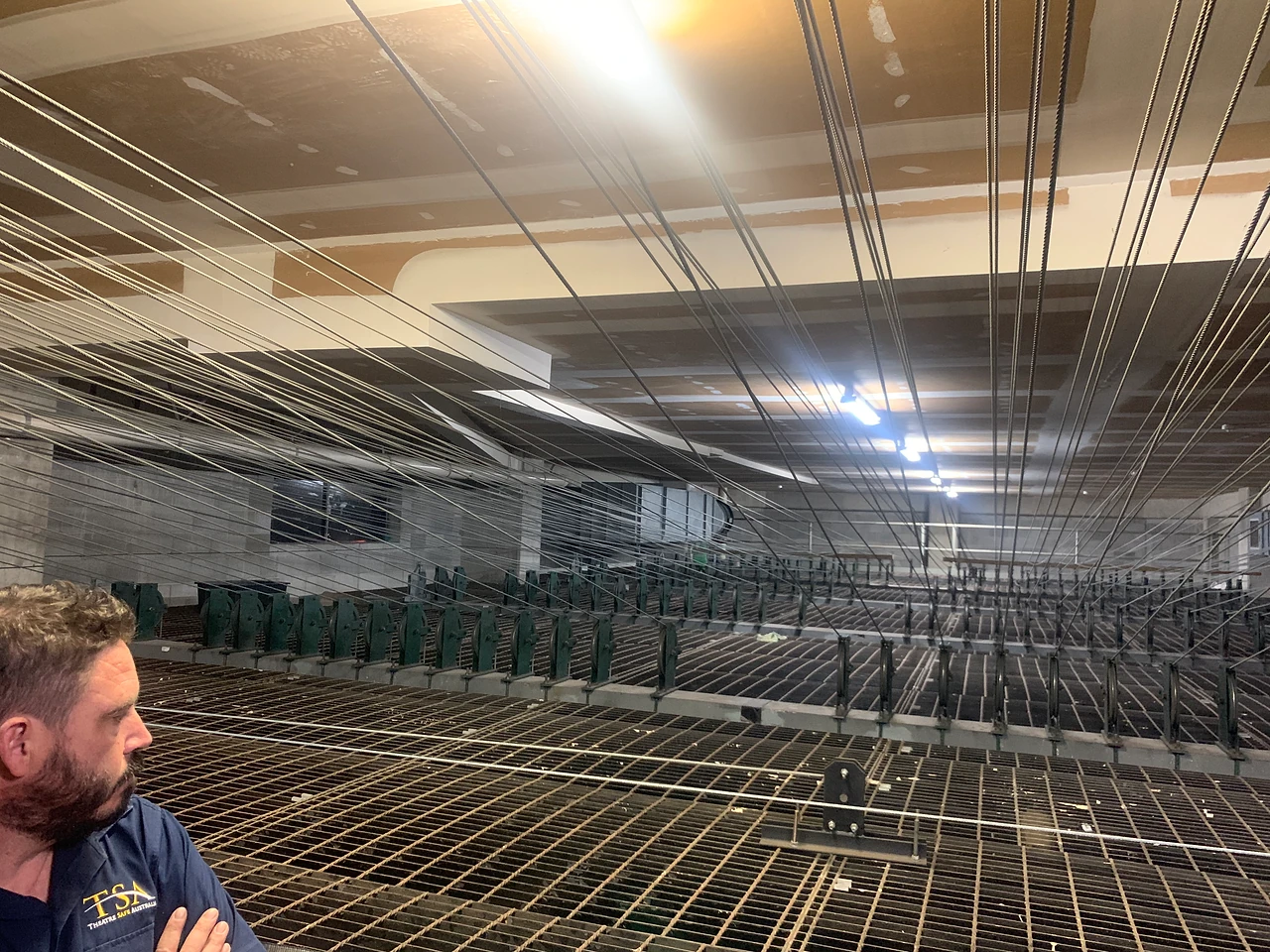

A TSA inspector on the fly floor at Gladstone Entertainment & Convention Centre during the annual inspection.

Five days, every asset on its own merits

The 2026 inspection ran across five days in January with two TSA inspectors on site. Every one of the 34 counterweight lines was assessed individually, along with the orchestra pit lift, the panorama winches, chain hoists, the overhead grid and the motor control systems, against AS1418, AS2550 and the manufacturers' specifications.

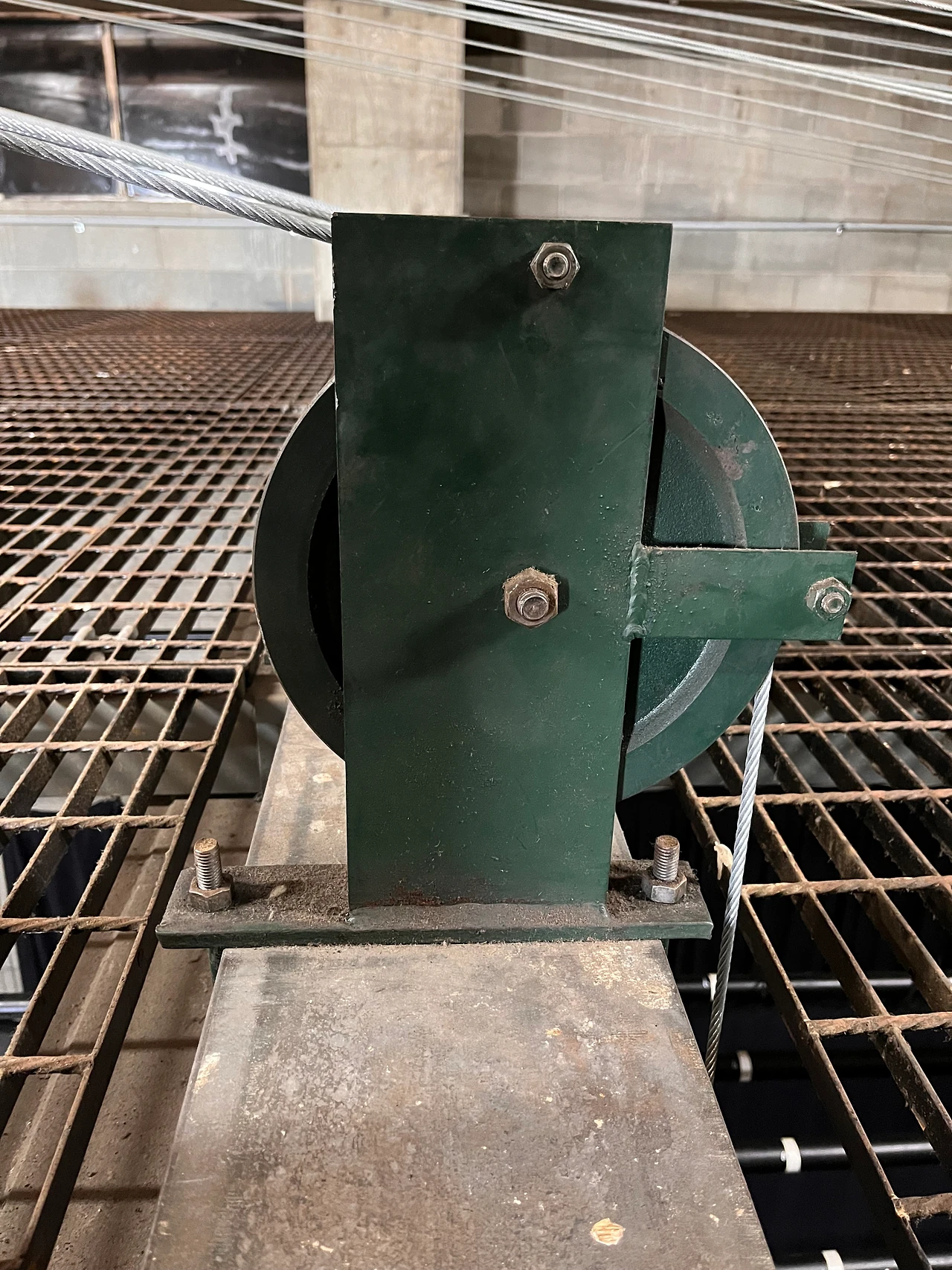

ii
Loft sheave and head block detail recorded during fly system rectification works at Gladstone.

Findings that get actioned, not filed

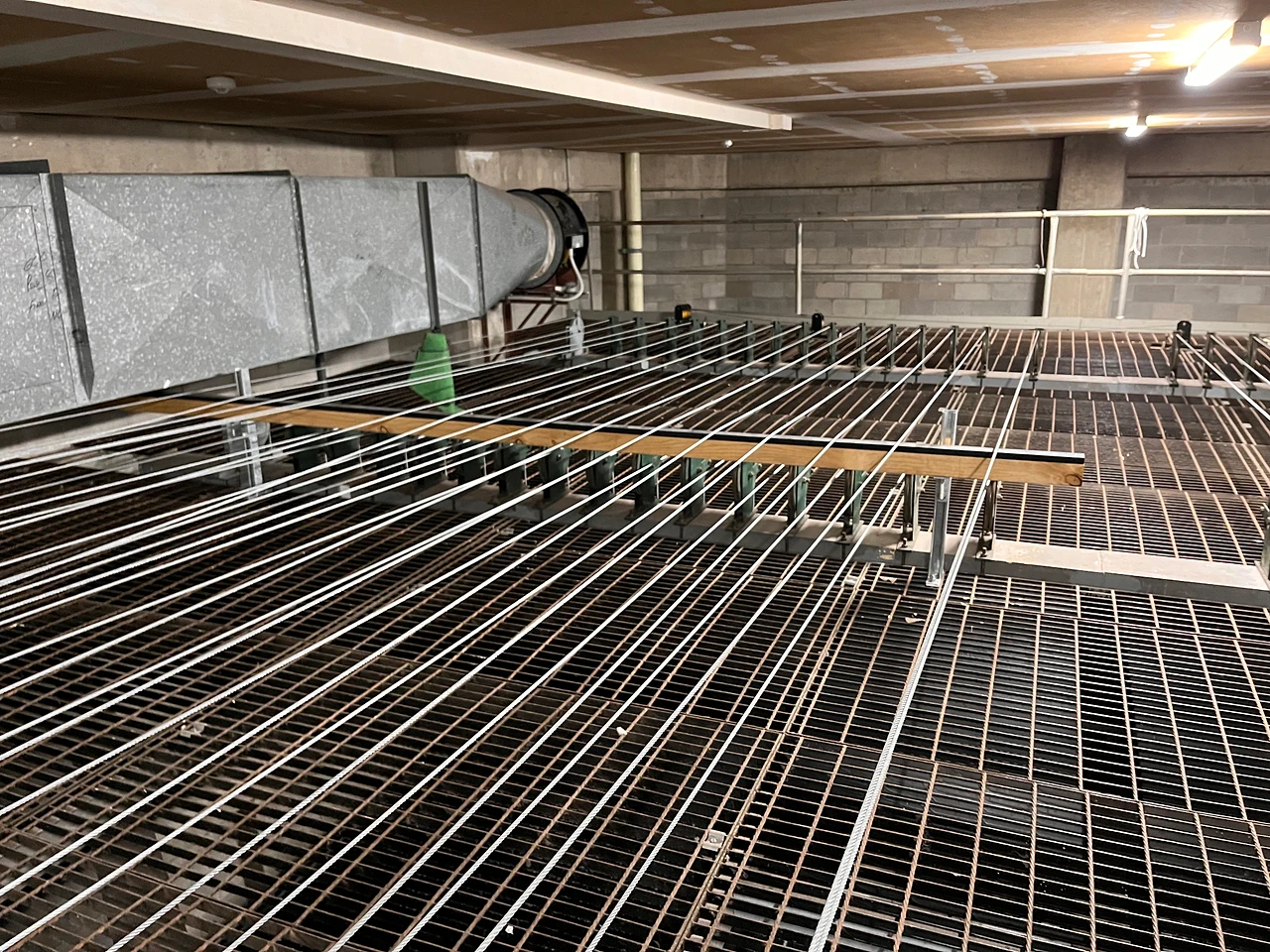

An inspection that ends at the report leaves the venue holding a list. The same relationship covers the work that follows, so Gladstone has had fly system rectification and orchestra pit rectification carried out by the people who identified the need for them, with replacement rigging equipment supplied through the same channel.

iii

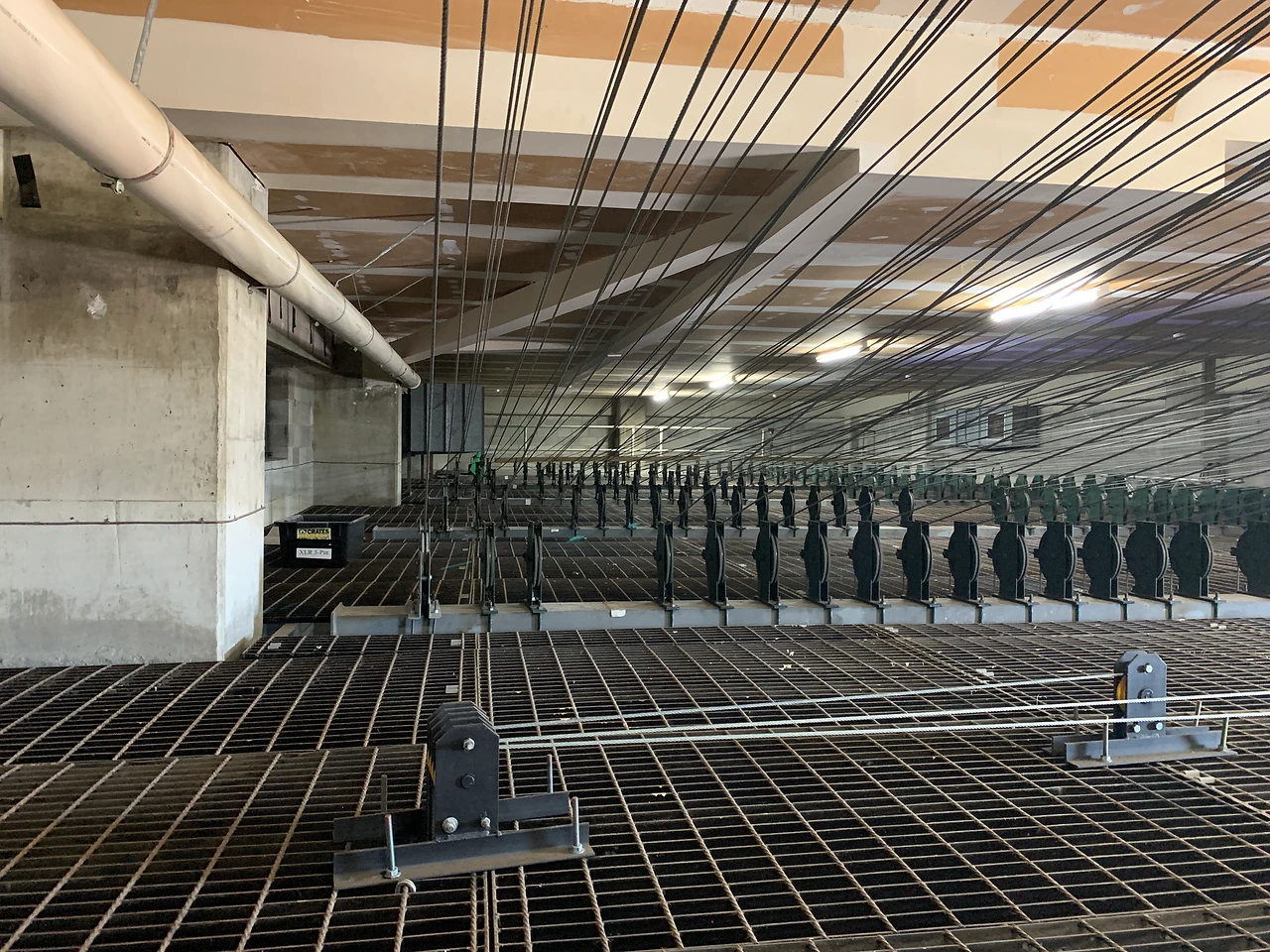

The counterweight house and overhead grid at Gladstone Entertainment & Convention Centre.

Certificates, and a record that builds year on year

Each inspection closes with individual certificates and a report in a consistent format, so the council can compare one year against the last rather than reading each one cold. That record is what turns a compliance obligation into lifecycle planning, and it is why the documentation matters as much as the spanner work.

03 The Result

Three terms, and counting.

TSA has held the stage machinery contract at Gladstone across three consecutive terms since the 2020 tender, and is contracted through to 2028. In that time the work has widened from inspection into rectification, equipment supply and production support, including performer flying for the venue's 2026 community musical.

That is the whole argument for an annual programme rather than a callout. The venue keeps its productions running, the council can budget against a known picture instead of a surprise, and the people who know the system are the same ones who show up next January.
